Stanley Pier reconstruction

Underwater welding, pile works and floating steel formwork for rebuilding a pier in open water, planned over 190 working days.

Year
2005
Location
Stanley, Hong Kong Island
Status
Completed
Category
Underwater & marine

Rebuilding a pier over open water means working below the tide line. We planned the whole job around a set of reusable waterproof steel formworks that are floated into position, sunk around each pair of piles to form a watertight mould for the concrete.

Sequenced in five stages

  • Day 30: underwater welding of I-beam ties between piles, removal of nine platform piles, a crane platform, and the first formworks at A7/F7 and A6/F6 with five cross beams. A7/F7 concreted.
  • Day 60: five more platform piles removed and the platform partly rebuilt, formworks moved to A5/F5 and A4/F4, four precast beams installed, A6–A5 concreted.
  • Day 90: formworks at A3/F3, four more precast beams, A4/F4 concreted.
  • Day 120: the A4/F4 formwork modified for A2/F2, formworks at A1–A2, precast stair beams.
  • Day 190: the last precast units at A1–A3, final concrete pours, formworks and pile ties removed, and the upper-deck working platform built.

Formwork designed to float

Each formwork unit was drawn with its own weight and buoyancy so it could be towed and placed without heavy lifting: the A3/F3 unit weighs 4.8 t with 28 t of buoyancy, A7/F7 7.5 t with 58.5 t, and the larger A5–A4 unit 14 t with 127 t. A temporary working platform was added in December 2005.

Drawings

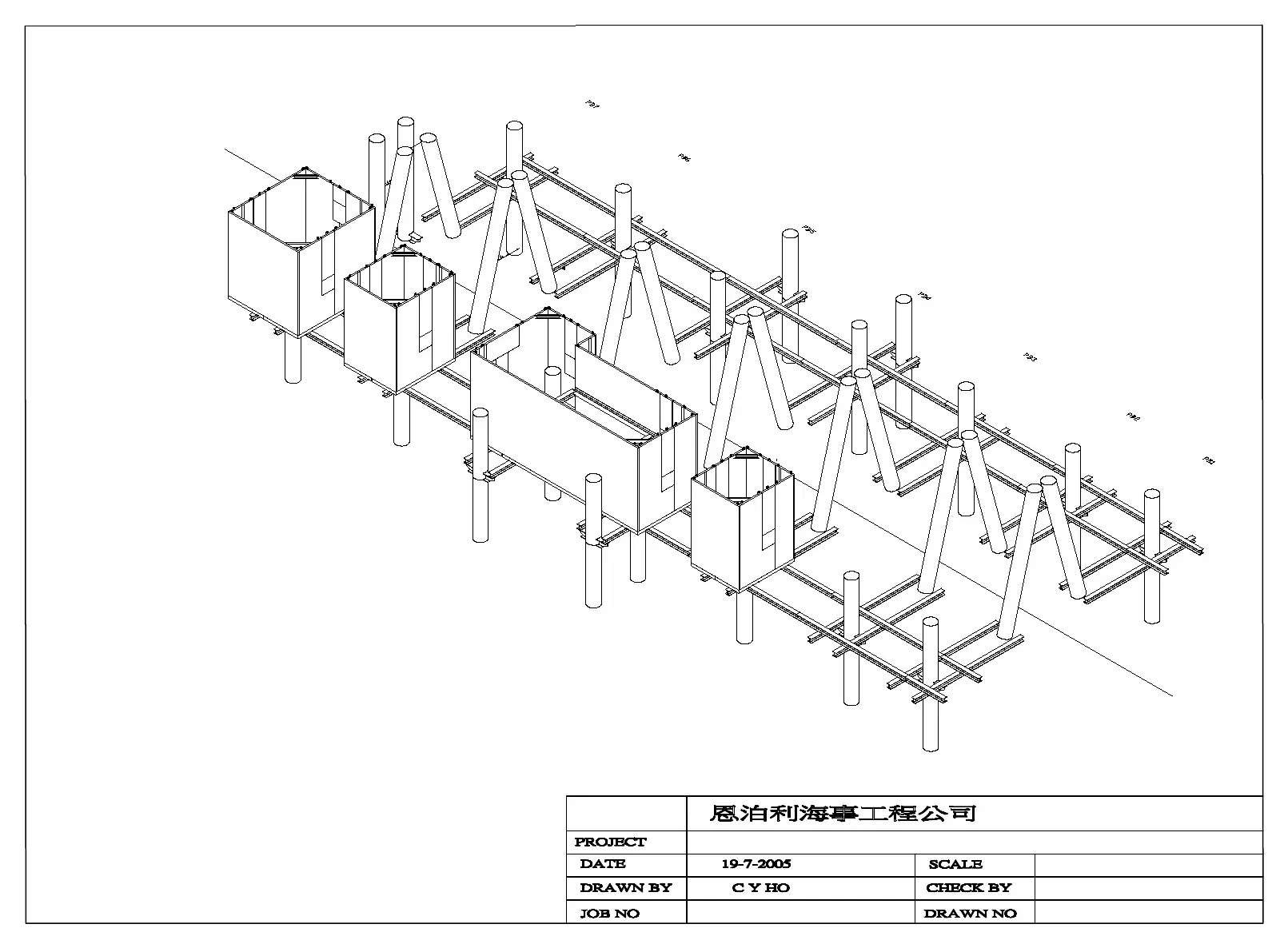

3D overview · 立體圖
3D overview · 立體圖

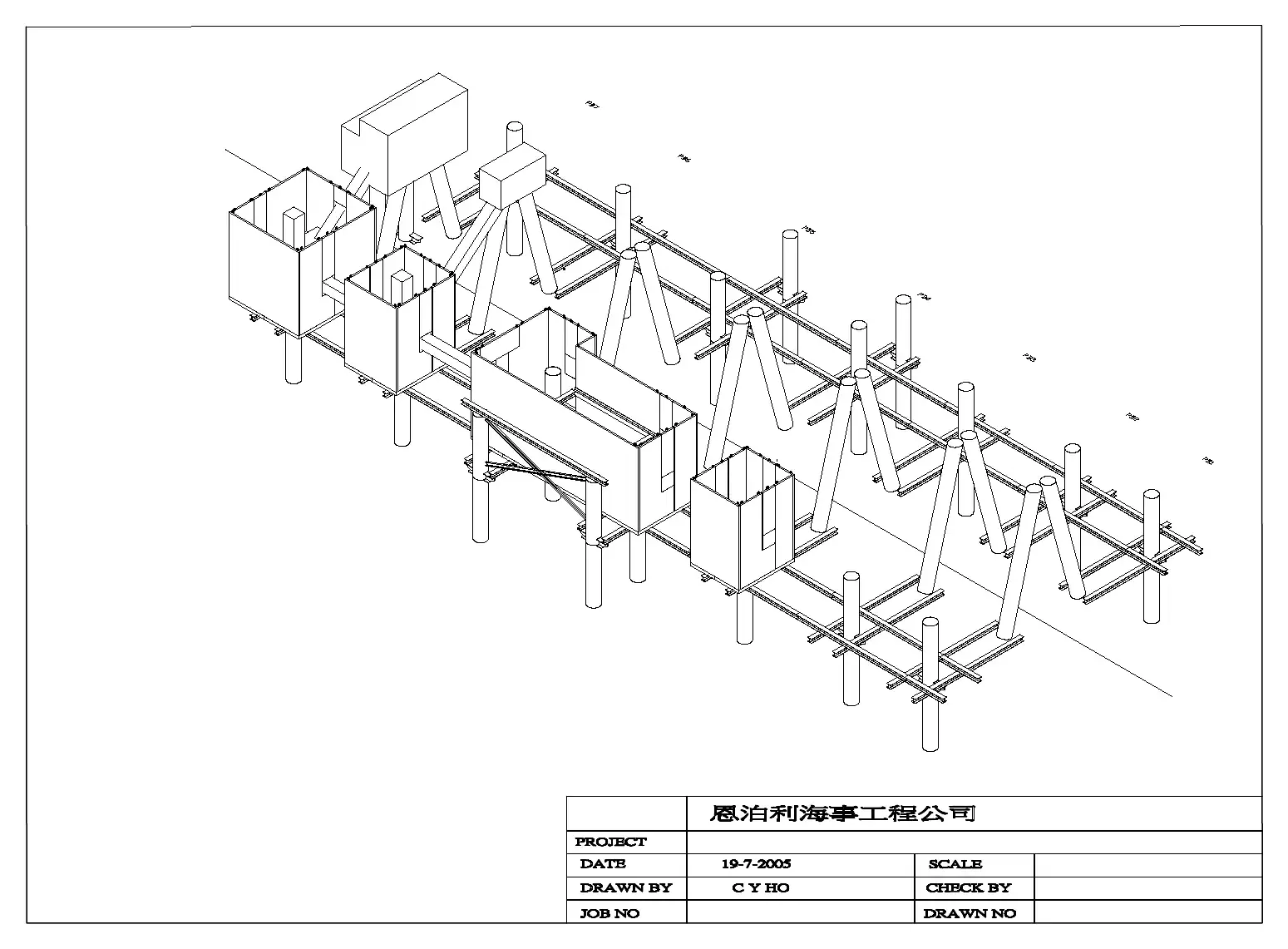

3D: formwork placement · 鐵模安裝
3D: formwork placement · 鐵模安裝

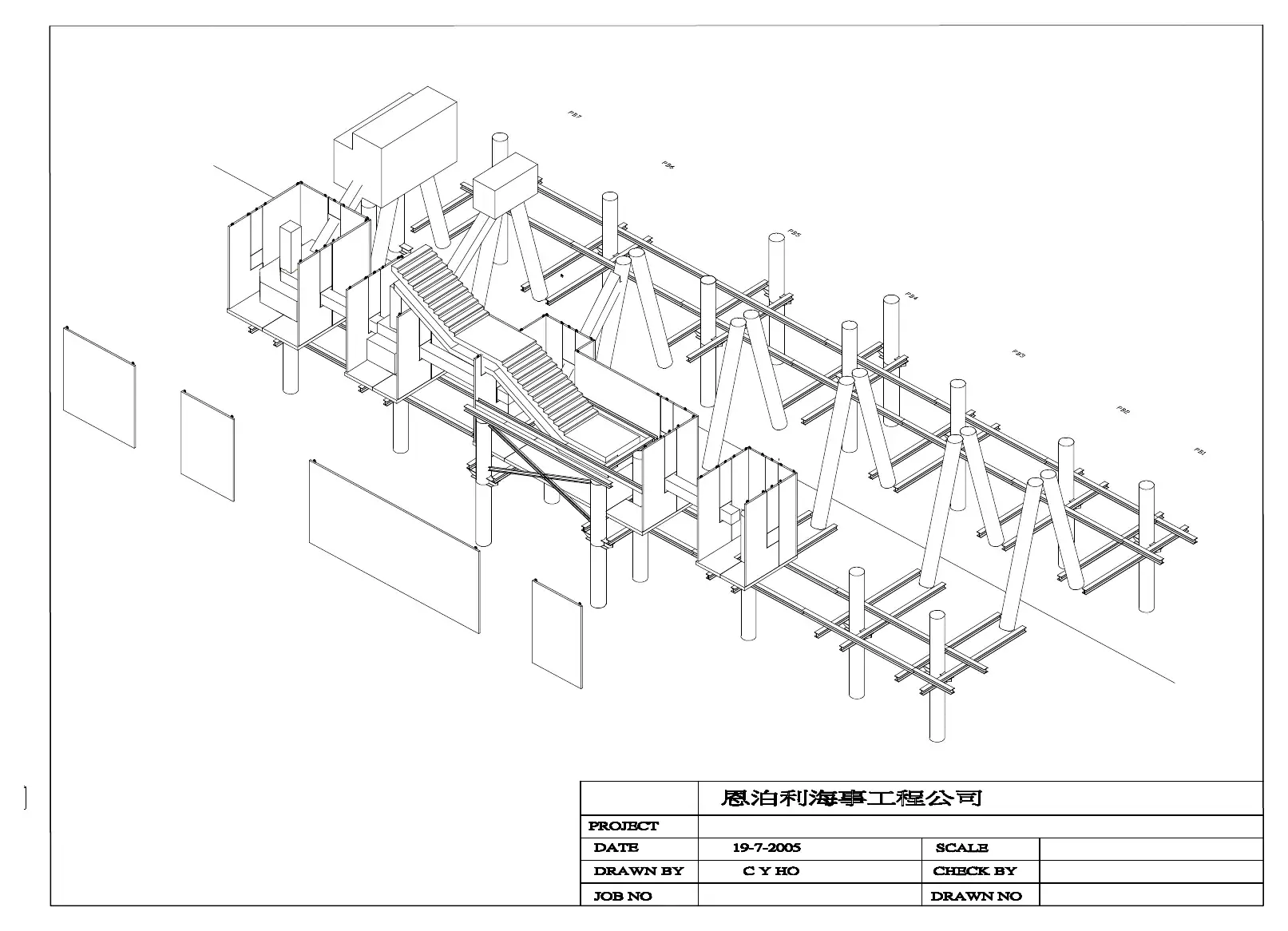

3D: stairs and deck · 梯級及樓面
3D: stairs and deck · 梯級及樓面

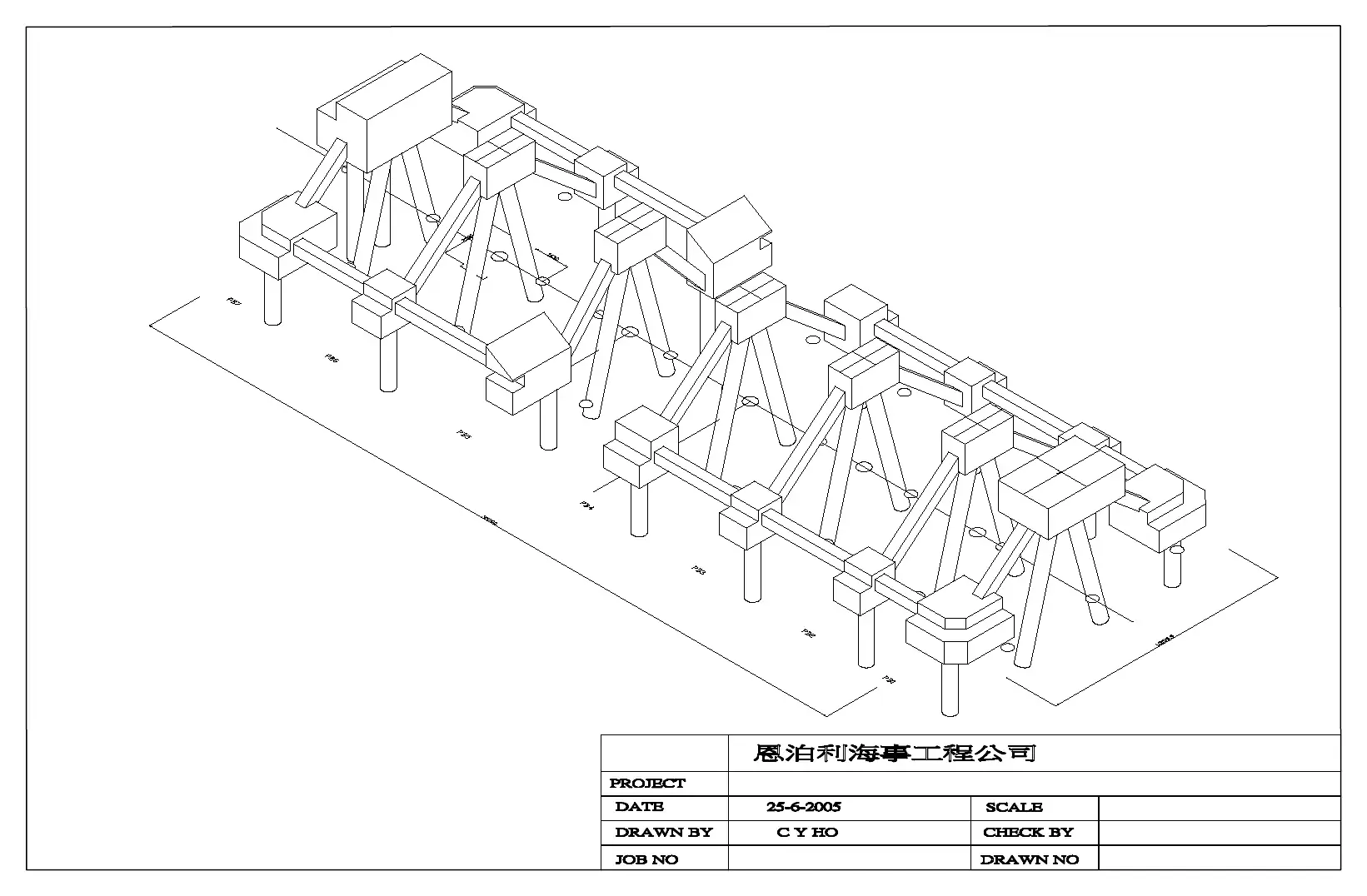

3D: completed structure · 完成結構
3D: completed structure · 完成結構

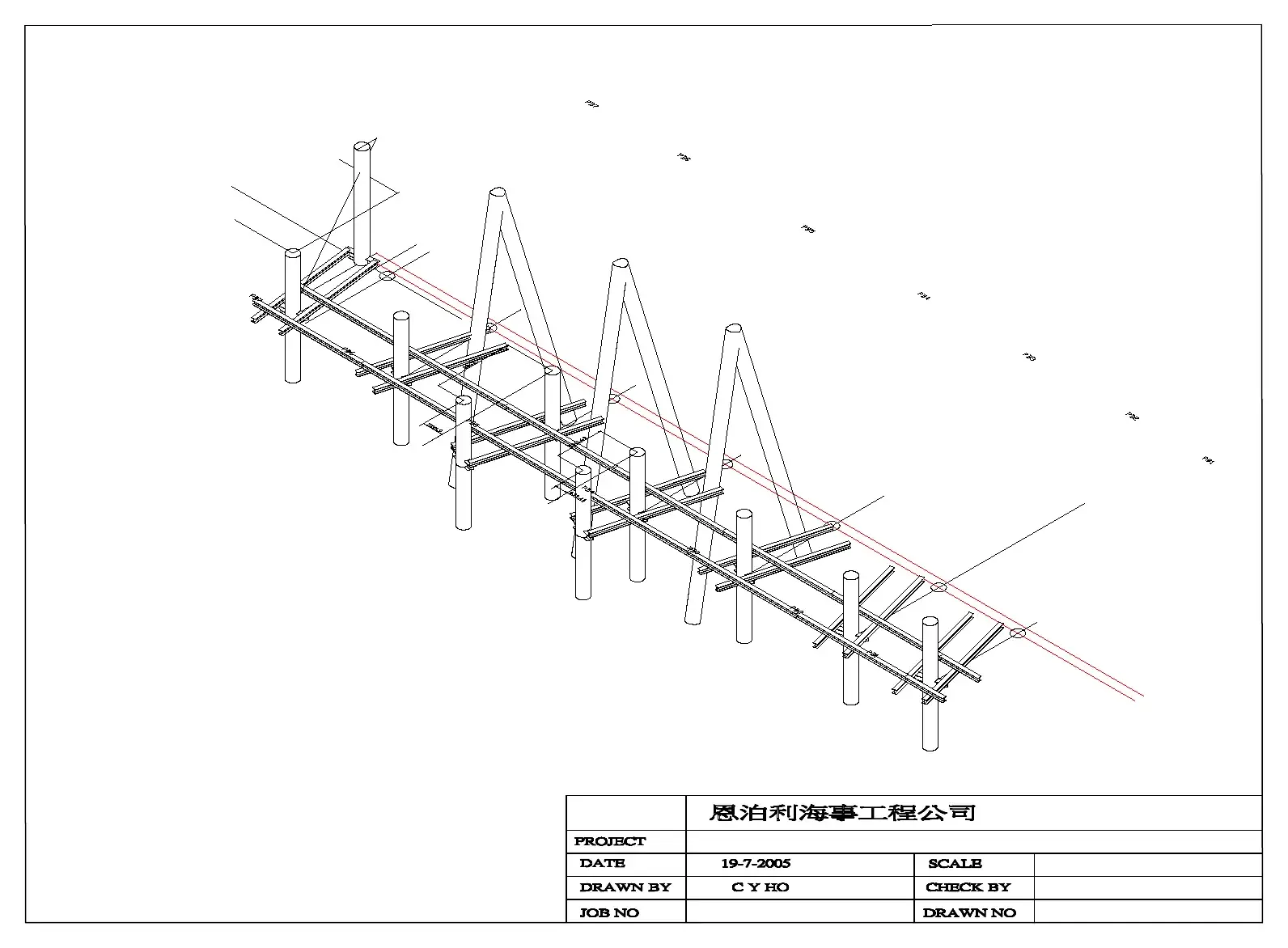

3D: pile layout · 樁位
3D: pile layout · 樁位

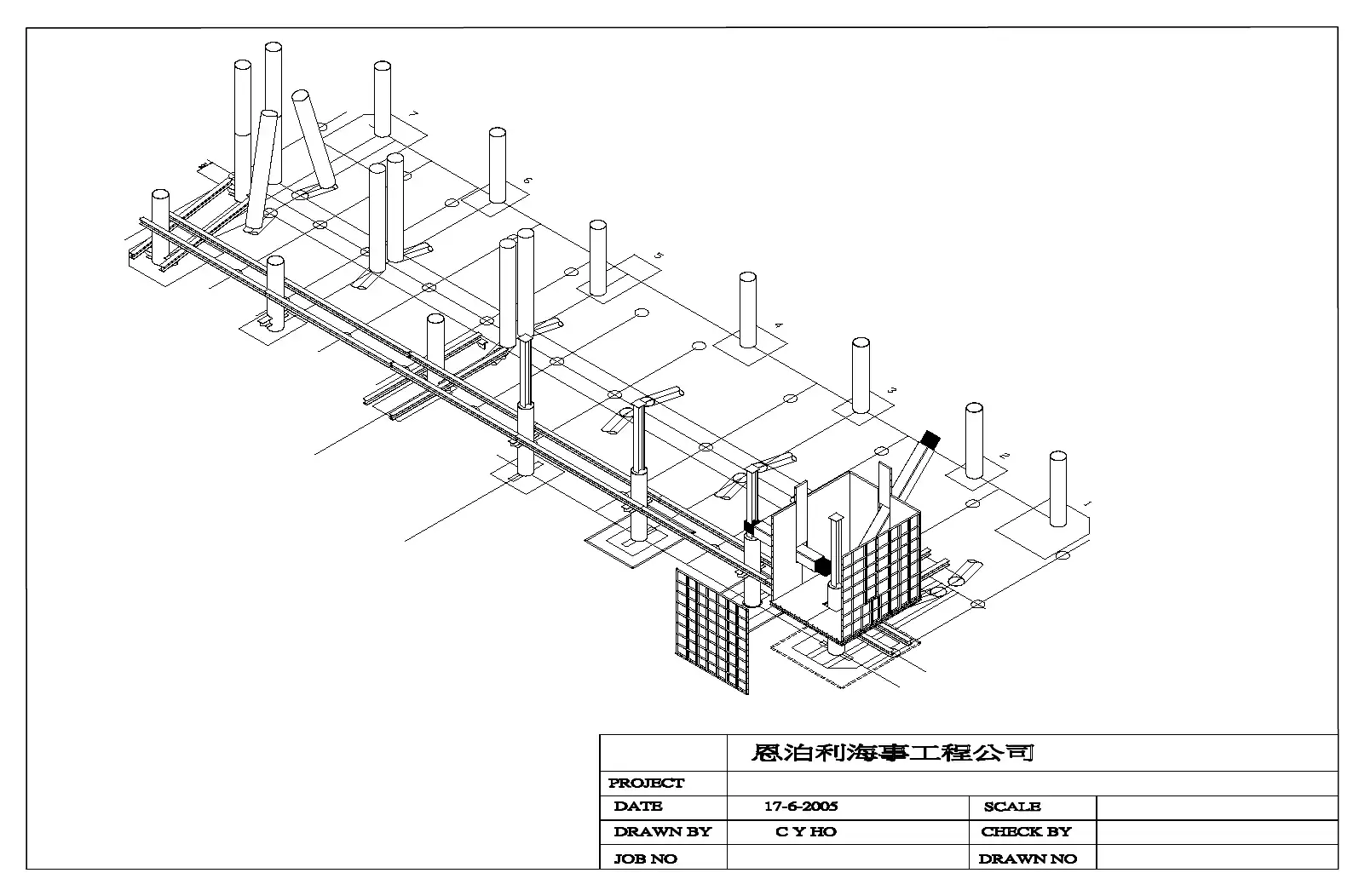

3D: temporary works · 臨時工程
3D: temporary works · 臨時工程

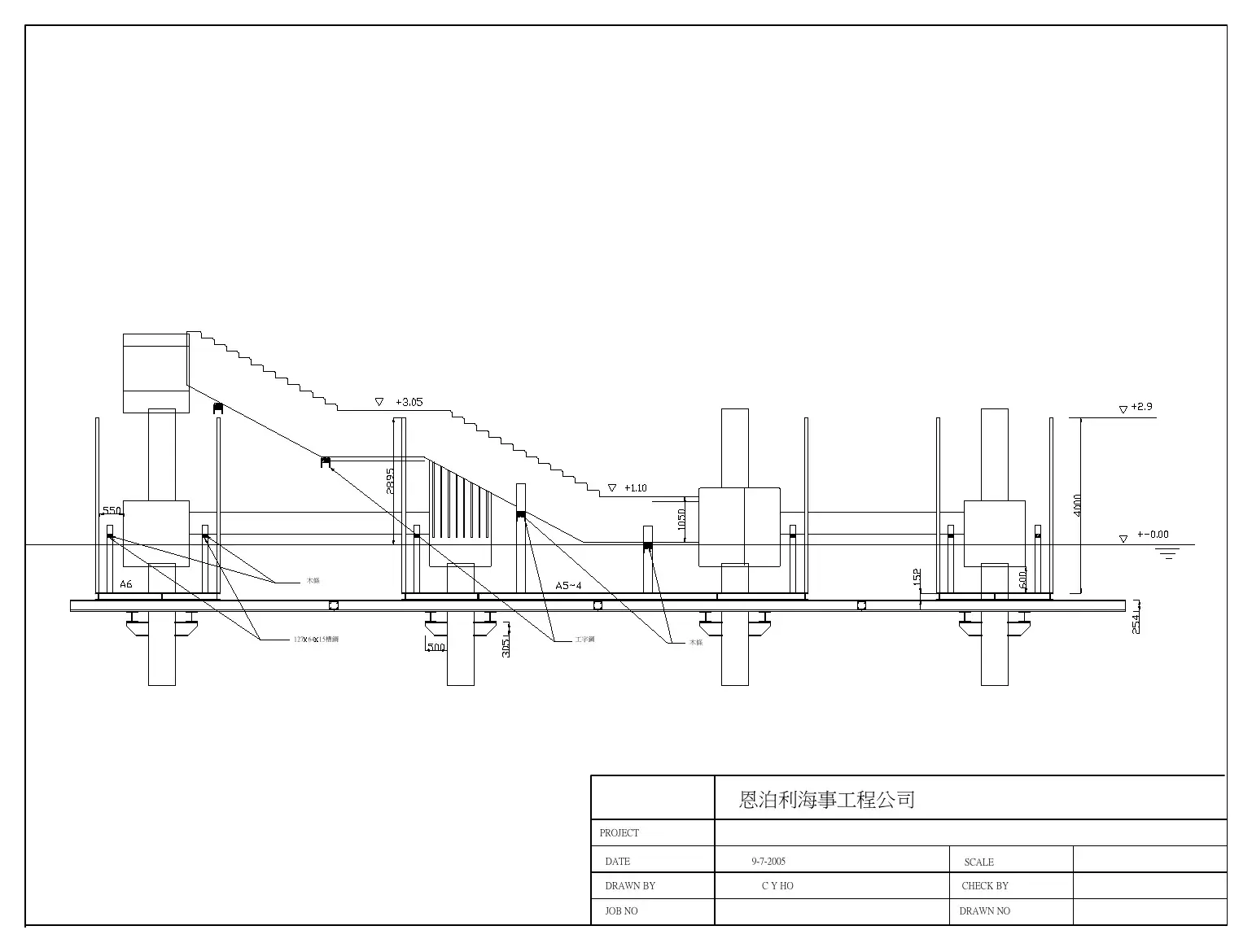

Elevation · 立面圖
Elevation · 立面圖

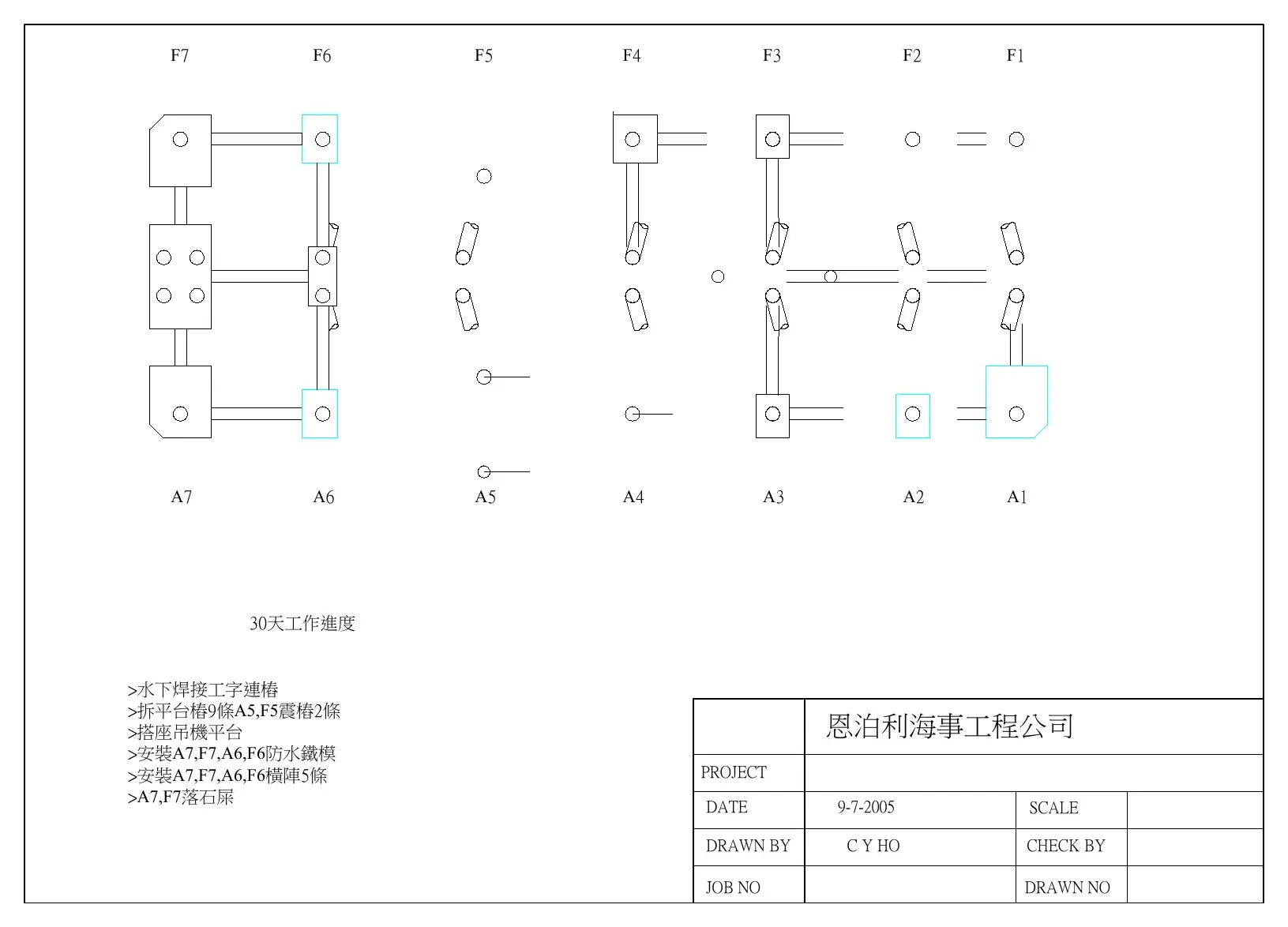

Stage 1, day 30 · 30天進度
Stage 1, day 30 · 30天進度

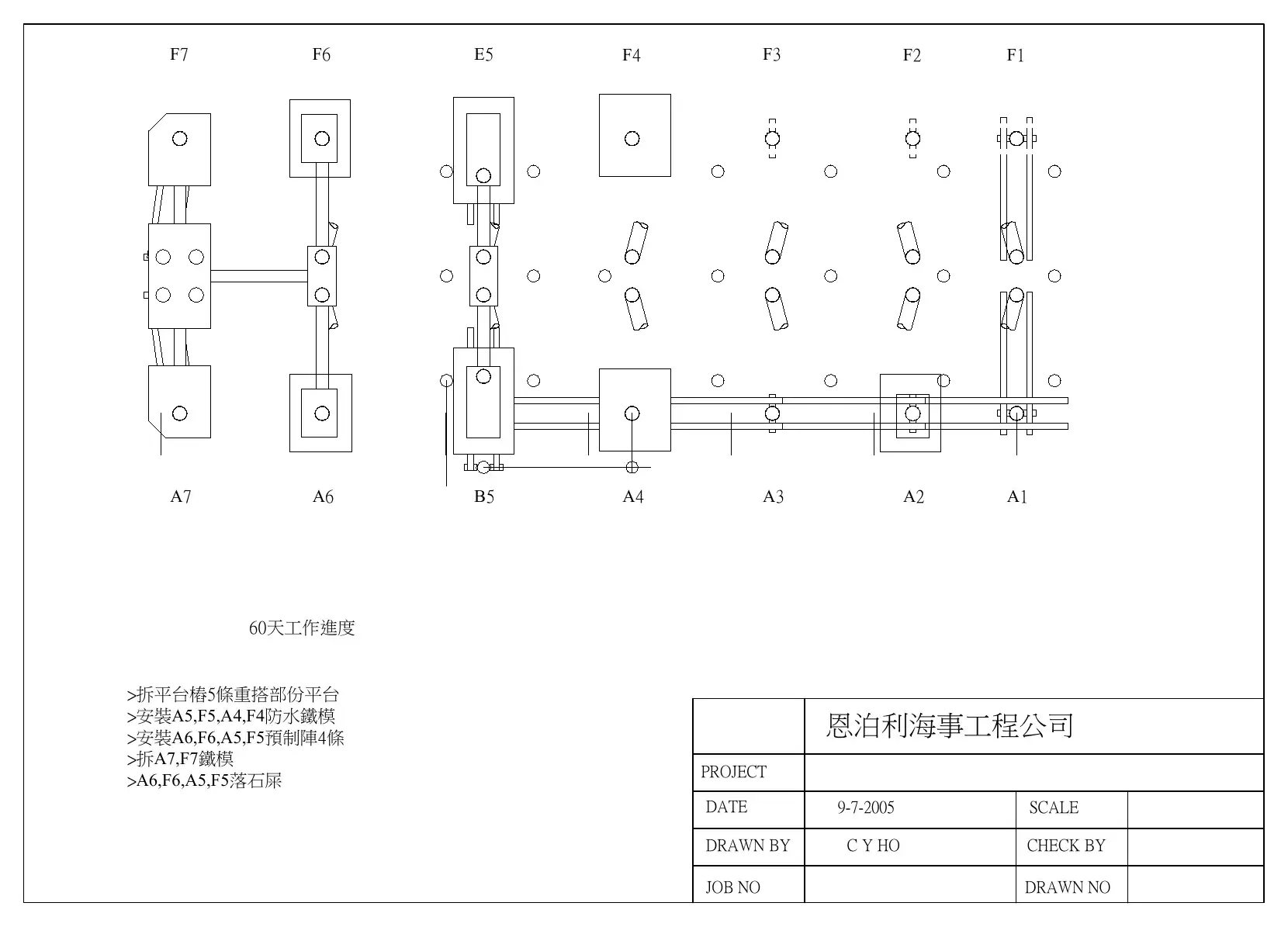

Stage 2, day 60 · 60天進度
Stage 2, day 60 · 60天進度

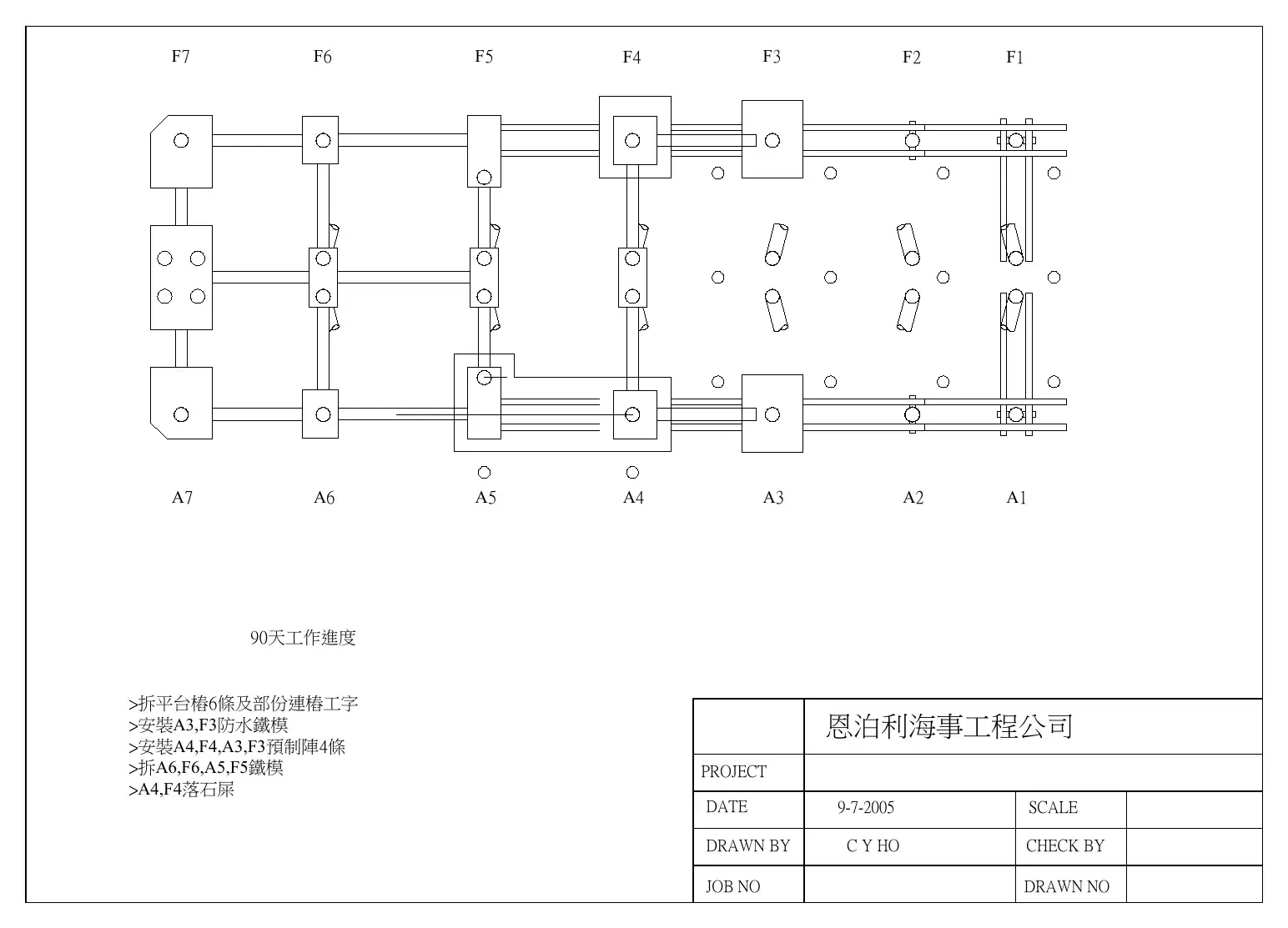

Stage 3, day 90 · 90天進度
Stage 3, day 90 · 90天進度

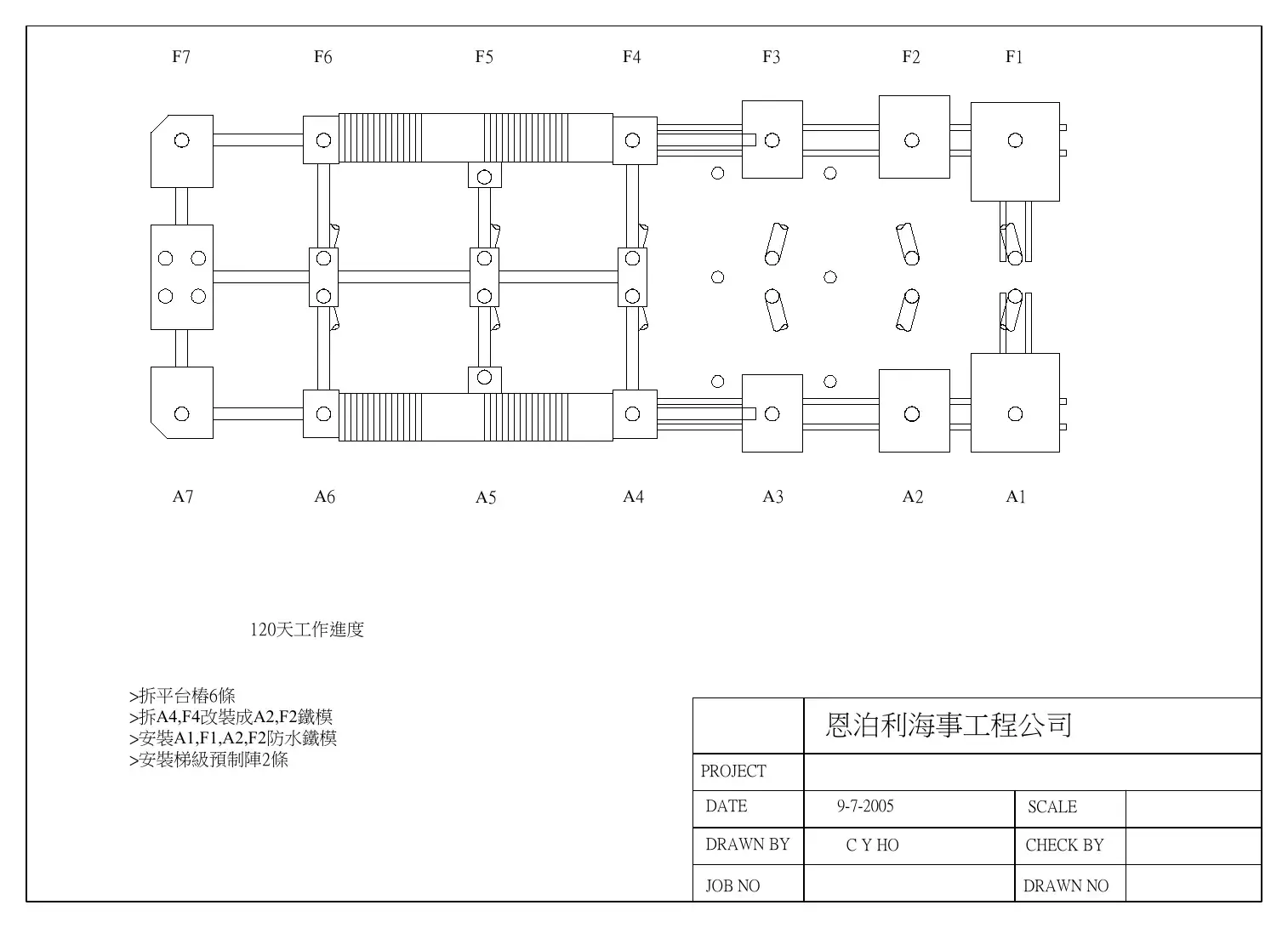

Stage 4, day 120 · 120天進度
Stage 4, day 120 · 120天進度

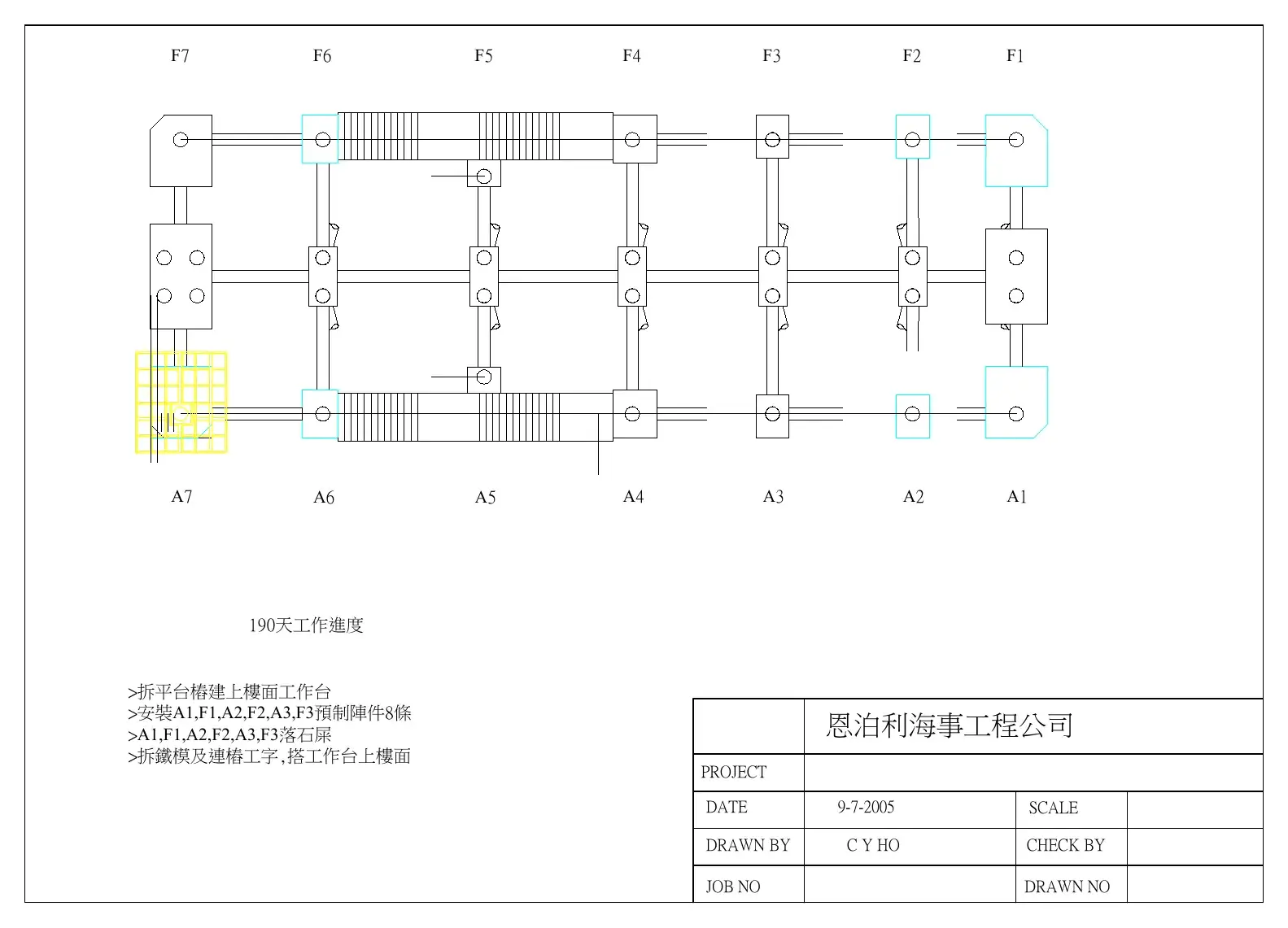

Stage 5, day 190 · 190天進度
Stage 5, day 190 · 190天進度

Formwork A3/F3 · 鐵模
Formwork A3/F3 · 鐵模

Formwork A7/F7 · 鐵模
Formwork A7/F7 · 鐵模

Formwork A5–A4 · 鐵模
Formwork A5–A4 · 鐵模

Formwork A6/F6 · 鐵模
Formwork A6/F6 · 鐵模

Temporary platform, plan · 臨時工作台平面
Temporary platform, plan · 臨時工作台平面

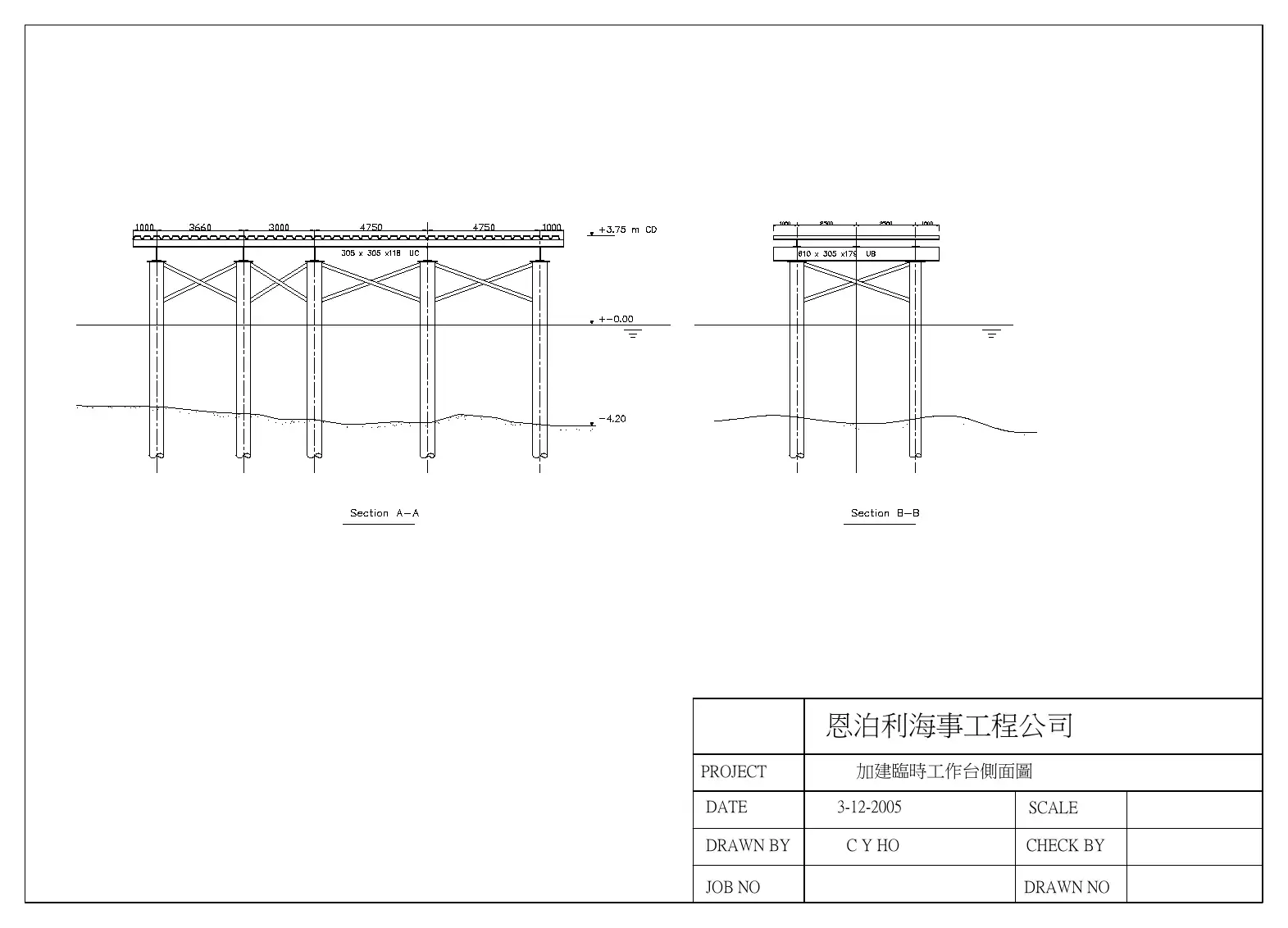

Temporary platform, elevations · 臨時工作台立面
Temporary platform, elevations · 臨時工作台立面
